GDH 1Q19 PHMC report
Archives 1006.01.139

First quarter 2019

George Douglass

The Historic Preservation Trust of Berks County, PA., Project ME Number 16709 George Douglass House Project work Accomplished January 1, 2019 to March 31, 2019 During the 1st quarter of 2019, our project plasterer (working on his 20th National Register structure) made substantial progress in the interior work, restoring wall integr

View record

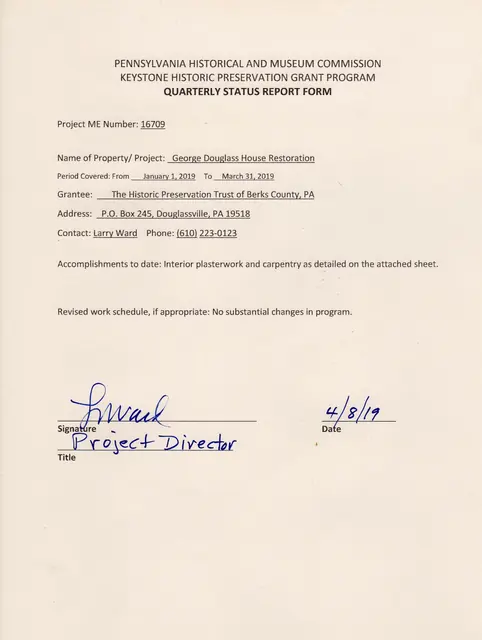

Quarterly Status Report Form
Archives 1006.01.054

George Douglass House Restoration Report for the quarter ending March 31, 2019

George Douglass · April 2019

The Historic Preservation Trust of Berks County, PA., Project ME Number 16709 George Douglass House Project work Accomplished January 1, 2019 to March 31, 2019 During the 1st quarter of 2019, our project plasterer (working on his 20th National Register structure) made substantial progress in the interior work, restoring wall integrity in th

View record
#1: Original cantilevered window lintel
Archives 1008.01.77

Sites and Structures Report April 2019

Sites and Structures Reports · April 2019

Sites & Structures Report, April, 2019: During the 2019 and 2020 restoration season, the Trust will substantially complete multi-year projects on the Mouns Jones and George Douglass houses, returning them to their respective 1716 and 1765 architectural forms, as documented by extensive evidence carefully considered and faithfully executed by our committe

View record
#1, photo 4: Reconstructed and plumbed west wall of Mouns Jones House
Archives 1008.01.074

Sites and Structures Report November 2016

Sites and Structures Reports · November 2016

I. MOUNS JONES HOUSE RESTORATION: During the late summer and early autumn of this year, the riverside wall of the Mouns Jones house was re-constructed from the foundation level to the timber plate [Image #1, photo 4, 10/10/16], which will bear the pocketed ends of the joists supporting the 2d story floor boards donated by the late Dr. Donald and Esther Shel

View record
Image #1: failed foundation plinth at NW corner, below grade
Archives 1008.01.071

Sites and Structures Report October 2014

Sites and Structures Reports · October 2014

Sites & Structures Committee Report, October, 2014 The following is a summary of stabilization, preservation, restoration, and related work planned, completed, and in-progress, including requested Board approval or other action on pending work and projects under consideration: I. MJH Wall restoration project: A. The disintegrated below-grade NW corne

View record
#1: Re-laid west wall, Mouns Jones House
Archives 1008.01.070

Sites and Structures Report October 2018

Sites and Structures Reports · October 2018

Progress to Date on restoration and site-improvement projects: I. Mouns Jones House: A. First story masonry wall facing the river was re-laid in September [Image #1, Photo 65, 8/27/18]. B. Paired cantilevered stone lintels have been set on stainless steel angles spanning the first story doorway [Images #2 and #3, photos #24, 10/3/18 and #7, 9/9/18, an

View record
#1 : Re-constructed corner cupboard in back parlor
Archives 1008.01.078

Sites and Structures Report-GDH, August 2020

Sites and Structures Reports · August 2020

Work Progress in George Douglass House, April 1-August 31, 2020: During this period, interior plastering and wood-work progressed in stages conforming to Pandemic restrictions as worker safety requires, including a rule allowing only one craftsman in the house on any work-day. The sequencing of plastering and woodwork was arranged to have all wooden "stops"

View record
#1: Preserved original [left] and new [right] plasterwork
Archives 1008.01.084

Sites and Structures Report-GDH, March 31, 2019

Sites and Structures Reports · March 31, 2019

George Douglass House Project work Accomplished January 1, 2019 to March 31, 2019 During the 1st quarter of 2019, our project plasterer (working on his 20th National Register structure) made substantial progress in the interior work, restoring wall integrity and surface finishes in the 2d floor chambers and hallway. This work progressed with the sensiti

View record
#1: Restored woodwork in back parlor
Archives 1008.01.079

Sites and Structures Report-GDH, March 31, 2020

Sites and Structures Reports · March 2020

Work Progress in George Douglass House, Oct, 2019-March 30, 2020 During this six month period, interior plastering and woodwork joinery continued at a steady and coordinated pace as weather, planning details, and Pandemic restrictions permitted. Our carpenters Tom & Chris Lainhoff fabricated and installed major paneled elements, built-in corner cabinetry,
